top of page
PROJECT UPDATES
Stay informed on how the Harrisburg SE Infrastructure project is progressing!
Subscribe to get email notifications letting you know that a new update has been posted.


2025 Construction to Begin
Hi everyone, Construction for 2025 will resume on March 31st. Below is a summary of the upcoming work as well as an image of the updated...
lwittler
Mar 102 min read
Contact Information for Irrigation and Landscaping
Hi everyone, The previous update included an incorrect phone number for the landscaping and irrigation contractor. The correct number for...
ahutchings0
Oct 31, 20241 min read


Project Status
Hi everyone, Construction for 2024 will be wrapping up within the next few weeks. Here is a summary of the remaining work. Phase 1-3...
ahutchings0
Oct 30, 20241 min read

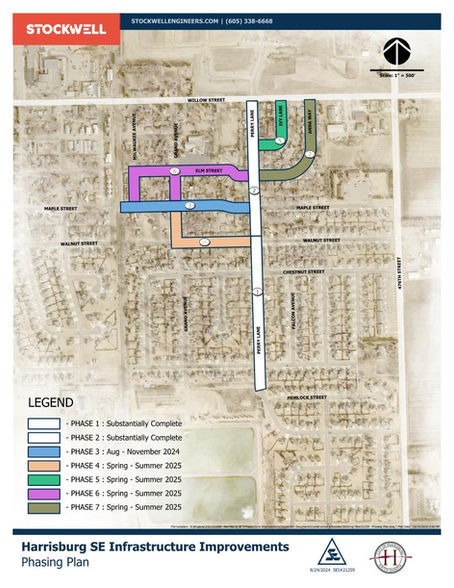

Schedule Update and Project Status
Hi everyone, Here is an updated project schedule, and since our last update, the Contractor has completed paving within Phase 3. Below is...
ahutchings0
Oct 24, 20241 min read


Maple Street Paving Completed
Hi everyone, The concrete crews have completed paving along Maple Street. The road will remain closed to traffic through next week. If...
ahutchings0
Oct 18, 20241 min read


Project Status
Hi everyone, Since our last update, the Contractor has installed most traffic signs, the majority of landscaping, and finished curb and...
ahutchings0
Oct 11, 20241 min read


Project Status
Hi everyone, Since our last update, the Contractor has completed most of the grading and topsoil installation along Perry Lane, and the...
ahutchings0
Oct 2, 20241 min read


Yard Restoration - Phase 1 and 2
Hi everyone, Construction crews have begun topsoil work south of Tiger Street, and will continue working north through Phase 1 and Phase...
ahutchings0
Sep 26, 20241 min read


Project Status
Hi everyone, Since our last update, the Contractor finished the underground installation along Maple Street and has begun installing...
ahutchings0
Sep 19, 20241 min read


Water Shutdown
Hi everyone, The Contractor will perform a water main connection near the intersection of Milwaukee and Maple on Monday (9/9). Water...
ahutchings0
Sep 6, 20241 min read
Perry Lane Update
Hi everyone, Perry Lane is now open to traffic and street parking. Please be aware of the temporary traffic signs at the intersections....
ahutchings0
Sep 4, 20241 min read


Project Status
Hello all, Since our last update, the Contractor finished concrete sidewalk and driveway work along Perry Avenue as well as installed...

stockwellengineers
Sep 3, 20241 min read


Schedule Update
Hi everyone! Here is the updated project schedule. Construction will stop for 2024 once Phase 3 has been completed, and the remaining...
ahutchings0
Aug 28, 20241 min read


Grand Ave & Maple St Intersection Closure
Greetings: Starting on Monday, 8/19 the intersection of Grand Ave and Maple Street will be closed to vehicular traffic for the duration...

stockwellengineers
Aug 16, 20241 min read


Project Status
Hello all, Over the last couple weeks the Contractor finished street paving and started sidewalk and approach work along Perry Avenue....

stockwellengineers
Aug 16, 20241 min read


Water Shutdown
Hello all, Water will be turned off to the properties illustrated in the map below. The shutoff will occur either Thursday (08/15) or...

stockwellengineers
Aug 14, 20241 min read


Phase 3 Temporary Mailboxes
Hello all, Temporary mailboxes for Phase 3 residents are setup on Elm Street near the parking lot of the Harrisburg United Methodist Church.

stockwellengineers
Aug 5, 20241 min read


Maple Street Closure & Project Update
Hello All, Starting Monday (08/05), Maple Street will close from Perry Lane west to the railroad tracks. The intersection of Grand Avenue...
lwittler
Jul 31, 20241 min read


Concrete Paving
Hello all, Concrete Paving was completed today along Perry Lane between Tiger and Chestnut Street. The contractor is advising that no...

stockwellengineers
Jul 24, 20241 min read
Concrete Sawing
Hello All, As a reminder, concrete paving is underway on Perry Lane. Like all materials, concrete expands, contracts, and cracks. To...

stockwellengineers
Jul 23, 20241 min read
bottom of page
